Lean Planning
“Give me six hours to chop down a tree, and I will spend the first four sharpening the axe” is an iconic quote from Abraham Lincoln that we’ve all probably heard at some point in our careers.
When building the world’s tallest mass timber hybrid building, Ascent, the project team took a similar approach.
In this post, we’ll explore the importance of a few lean construction practices and planning principles that can be applied to any project.
By sharpening our axe, we can effectively and efficiently execute a project, deliver it on time, within budget and minimize waste and rework.
Preconstruction planning for Ascent began eight months before ground broke in August 2020. Early on, the project team understood that successfully building the world’s tallest timber tower would require a collaborative effort.
The level of preconstruction planning and coordination required was intense. Plans called for the mass timber columns, glue-laminated beams and cross-laminated timber (CLT) panels to be prefabricated offsite and shipped to the location for installation.
Prefabrication is an effective way to eliminate waste, focus on flow and optimize the overall project.
By taking advantage of prefabrication opportunities, significant cost savings can be realized while reducing the overall construction schedule.
However, the lead time for the overseas prefabrication and delivery was six months for the Ascent project. This needed to be accounted for in the master phased schedule.
To add to the project’s complexity, all the mechanical, electrical and plumbing (MEP) penetrations needed to be completed offsite in the material fabricator’s shop. This required the team to think about the process with the end in mind, virtually coordinating and digitally measuring every opening.
Here’s where it gets tricky. The columns at the base of the building are significantly larger than those at the top. The mass timber columns get smaller as a function of the proportionate building load reduction as you travel vertically up the floors of Ascent. At the same time, the on-center distance between screws decreases as the overall dimensions of the column decrease.

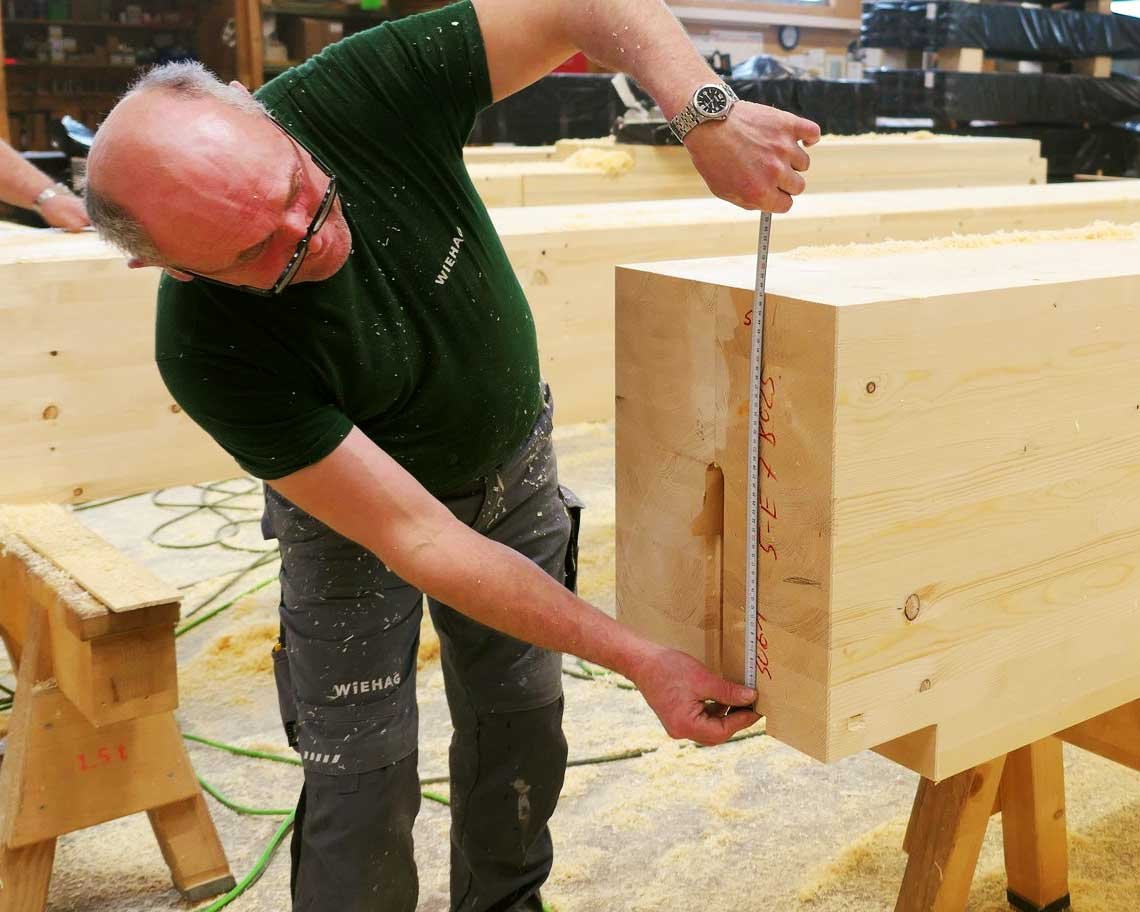

The placement of the 16” screws needs to adjust on the posts to accommodate the smaller column while not running into another adjacent 16” screw on the same column.
The placement of screws on a column is a significant problem if you discover it during installation. If the columns were identically prefabricated with the drill holes set in the exact same location on every column, when it came time to install the columns, the screws would clash.
The clash would cause rework, RFIs, wasted product and lost time. By looking at every part of the project individually and having foresight, we can identify potential problems and prevent errors from happening on a project.
To avoid a prefabrication catastrophe on Ascent, cross-functional teams held 64 meetings, each over three hours long.
During these meetings, teams utilized Virtual Design and Construction (VDC) and Building Information Modeling (BIM) to identify potential clashes and create a phased master schedule with specific hand-offs between trades to streamline workflow.
By using collaborative meeting technologies and accessing interactive visual displays, design teams across the country and local cross-functional teams could obtain a unique perspective on the project and have a heightened understanding of the information they needed to guide the project successfully.
Accurate, detailed 3D visuals also helped production and installation teams during the construction process.
When it came time to erect Ascent, it was like a series of massive Lincoln Logs being assembled.
CLT panels were numerically placed in reverse order for shipping and transportation. Once they arrived at the jobsite, crew members could pull the panel they needed in the correct order without moving any other panels, streamlining the assembly process.
On the other hand, the column and beams were strategically packed to reduce transportation costs. Once they arrived onsite, crews came up with an idea to pick multiple bundles of columns and beams off the truck and then land them at a structurally engineered location on the deck for sorting and erecting. Then the crew could make mini picks from the bundles to set each column and beam.
When crews began assembling the first floors of Ascent, it would take 7-8 days to complete a single floor. With a culture of respect, crew members felt valued and excited to share ways to become more efficient. By the time they got to the seventh floor of mass timber, crews were hitting their stride and completing a floor every five days, cutting their time by nearly 40 percent!
If you look at the projects you are working on, are there opportunities to sharpen your axe before striking and apply a lean principle or two?
Focus on what your target delivery looks like. Then think about getting project partners involved early on and building common ground to execute a project successfully.
Through early team involvement, architects, engineers, construction managers, trades partners and material suppliers could collaboratively identify, address and bring this record-setting mass timber hybrid building to life.
Additionally, by fostering a culture of collaboration and respect for the individual, teams became more engaged, productive and innovative, which ultimately saved time and money on the final project delivery.
